Release markers

7. Release markers

A release marker is a story with type: release and a release_date, acting as a date stake in the priority list that says "everything above this needs to ship by then."

The meadow fixture has two: First-frost (target Jun 17) and The Long-Sleep (target Aug 16, when Bear hibernates). They sit at meaningful seams, outdoor work above First-frost, indoor work above The Long-Sleep.

7.1 The marker in the backlog

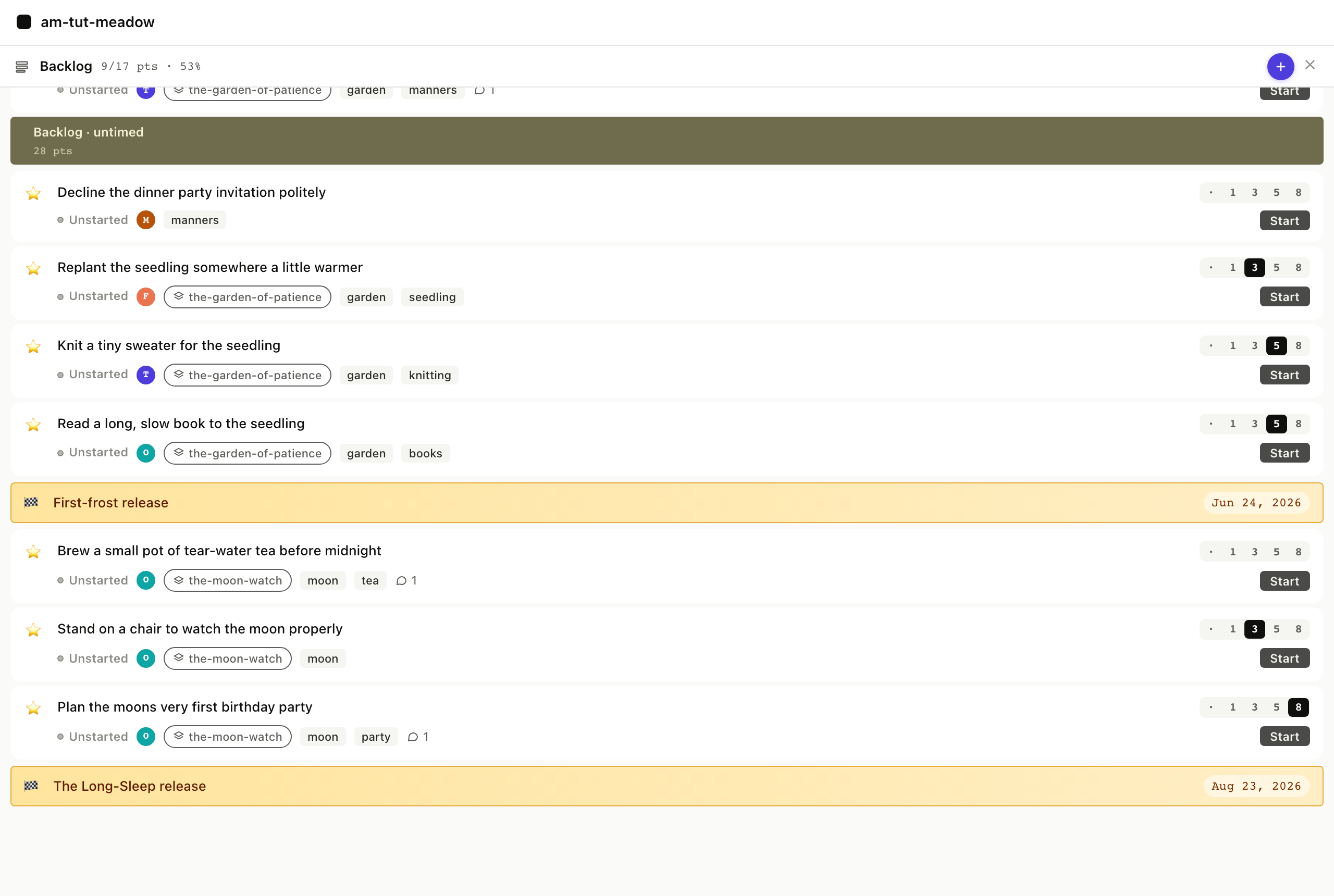

In the board, release markers render as a horizontal amber bar with a checkered flag and the target date in a pill. They're visually distinct from story cards because they aren't stories.

Their position in the priority list determines whether the system says they're on track or LATE. am show priority walks down the list, accumulates points against velocity, and when it crosses the marker's row asks whether the running iteration lands before the release date: if so the marker is on track, otherwise it is LATE.

$ am show priority --iterations 5
...
── Backlog (untimed) ──
  ★  Replant the seedling          unstarted   3p
  ★  Knit a tiny sweater            unstarted   5p
  ★  Read a long, slow book         unstarted   5p
  ▶  First-frost release            unstarted
       on track: target 2026-06-17
  ★  Brew a small pot of tea        unstarted
  ★  Stand on a chair               unstarted   3p
  ★  Plan the moon's birthday       unstarted   8p
  ▶  The Long-Sleep release         unstarted
       on track: target 2026-08-16

priority_list returns release markers in the same items array, distinguished by type: "release" and a release_date field.

Full envelope
{
  "jsonrpc": "2.0",
  "method": "tools/call",
  "params": {
    "name": "priority_list",
    "arguments": { "backlog": "stories" }
  }
}

The on-track / LATE projection is rendered by iteration_view which the agent calls explicitly when it needs the math; the raw row in priority_list just carries the date.

Re-rank a story above First-frost and the projection might flip to LATE; agilemarkdown recomputes whenever the list changes.

7.2 Creating a release marker

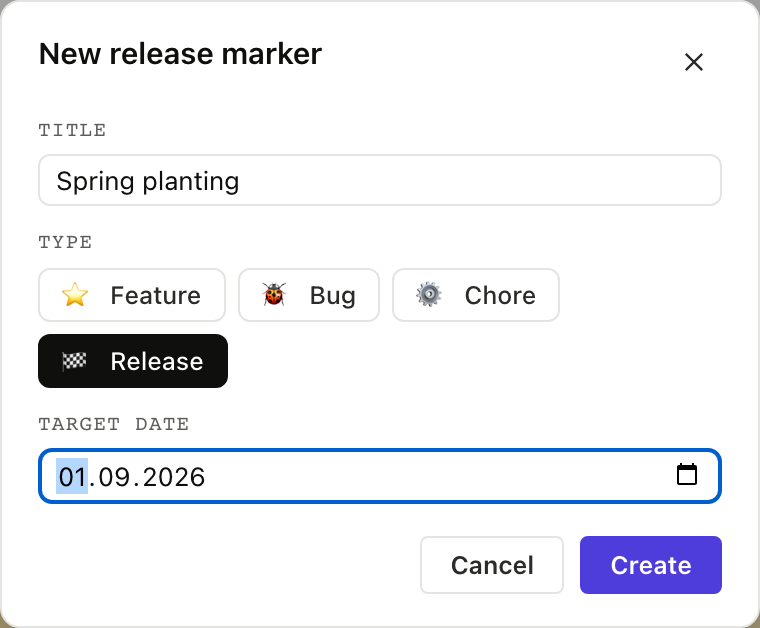

In the New Story modal a fourth type chip 🏁 release reveals a date picker when selected; submit the form and the new marker lands in priority. From the CLI it takes three calls (create-item, set-type, set-release-date):

$ am create-item "Spring planting"
created stories/spring-planting.md
$ am set-type stories/spring-planting.md release
spring-planting.md type=release
$ am set-release-date stories/spring-planting.md 2026-09-01
spring-planting.md release_date=2026-09-01

The web modal does the same three operations in sequence. The MCP equivalent is two tool calls: create_item and set_release_date (there's no set_type MCP tool, agents edit the story file directly via set_description or via the type-aware variants of other tools).

Full envelope
{
  "jsonrpc": "2.0",
  "method": "tools/call",
  "params": {
    "name": "create_item",
    "arguments": { "backlog": "stories", "title": "Spring planting" }
  }
}

then

{
  "jsonrpc": "2.0",
  "method": "tools/call",
  "params": {
    "name": "set_release_date",
    "arguments": {
      "path": "stories/spring-planting.md",
      "release_date": "2026-09-01"
    }
  }
}

7.3 Shipping a release

The day the release ships, the marker gets accepted. On the bar, once the target date is today or earlier, a green Ship button appears. Click it; agilemarkdown stamps accepted: <now> and the marker rolls into the Done panel at its actual ship week. The CLI verb is just am accept.

$ am accept stories/first-frost-release.md
✓ status: accepted   accepted_at: 2026-06-17T12:00:00Z

Shipping a marker is the same set_status call with status: "accepted", run against the release item. Release stories skip started/finished/delivered, so accepting one simply stamps its ship date and rolls it into Done.

Full envelope
{
  "jsonrpc": "2.0",
  "method": "tools/call",
  "params": {
    "name": "set_status",
    "arguments": {
      "path": "stories/first-frost-release.md",
      "status": "accepted"
    }
  }
}

The marker leaves the active priority view once accepted; next Monday it moves to Done. The ship date in Done is a fact and does not get recomputed when velocity shifts.

Next: The Done panel is just history →
