← Tutorial
Chapter 06

Epics and ETA

6. Epics and ETA

An epic in agilemarkdown is just a slug: any story with epic: <slug> in its frontmatter belongs to it, and there is no separate "epic" object beyond the slug itself. The board's Epics column rolls each slug up into a card with counts, progress, and a projected ship date.

6.1 A finished epic

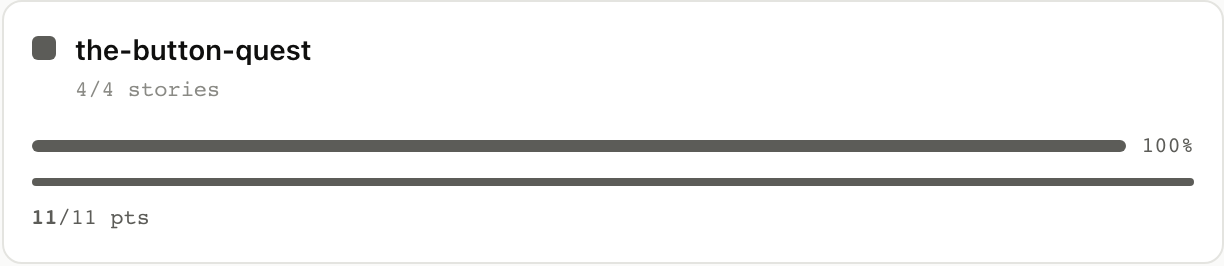

the-button-quest is four stories, all accepted in prior weeks, and the roll-up shows 4/4 stories, 11/11 points, 100%. No ETA is needed since the epic is already history.

$ am show epic the-button-quest
Epic: the-button-quest   4/4 stories  11/11 pts  100%
[████████████████████████]

Accepted:
  ★  Count all the buttons in a small wooden box
  ★  Find a small white button
  ★  Look in the bushes near the pond
  ★  Wear the brown coat the whole afternoon

epic_progress returns the same counts plus the ASCII bar.

Full envelope
{
  "jsonrpc": "2.0",
  "method": "tools/call",
  "params": {
    "name": "epic_progress",
    "arguments": { "slug": "the-button-quest" }
  }
}

Response: {total_stories: 4, accepted_stories: 4, total_points: 11, accepted_points: 11, percent_done: 100, ascii: "..."}.

6.2 An in-flight epic with a projected ETA

the-garden-of-patience is twelve stories, six accepted, several in flight, more unstarted in priority. Every story has an estimate, so the client computes an ETA from remaining_points / velocity, anchored to the next sprint Monday.

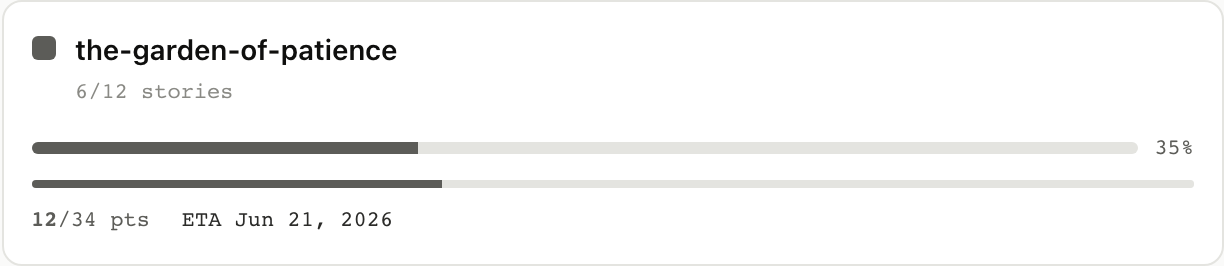

The card reads "6/12 stories, 12/34 pts, 35%, ETA Jun 21, 2026", with the bar showing the visible fraction and the date showing the math behind it.

$ am show epic the-garden-of-patience
Epic: the-garden-of-patience   6/12 stories  12/34 pts  35%
[████████░░░░░░░░░░░░░░░░]

ETA isn't computed server-side, the React tree does it from remaining_points (everything not yet accepted) and the project velocity from priority_list. The MCP tool returns the raw numbers so any agent can compute its own projection.

Full envelope
{
  "jsonrpc": "2.0",
  "method": "tools/call",
  "params": {
    "name": "epic_progress",
    "arguments": { "slug": "the-garden-of-patience" }
  }
}

What just happened (math)

remaining_points = total_points - accepted_points
sprints_to_ship  = ceil(remaining_points / velocity)
eta_monday       = next_monday + sprints_to_ship weeks

For the garden epic: (34 − 12) / 7 ≈ 4 sprints. Counting that many sprint Mondays out from the current sprint lands on the date the card shows, Jun 21, 2026.

6.3 An epic that can't be projected

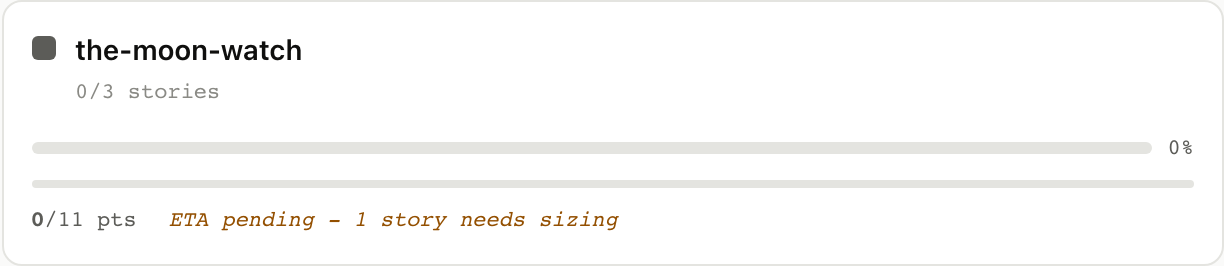

the-moon-watch is three stories, two with point estimates and one (brew the tea) still unsized. The card shows the counts it has (0/3 stories, 0/11 pts) but refuses to commit to a date, surfacing ETA pending, 1 story needs sizing in its place. The rule is that agilemarkdown will not fake a forecast it cannot compute: as soon as the missing estimate lands the ETA appears.

$ am show epic the-moon-watch
Epic: the-moon-watch   0/3 stories  0/11 pts  0%
[░░░░░░░░░░░░░░░░░░░░░░░░]

epic_progress returns the counts and total_points (here, the 11 points from the two estimated stories); the structuredContent does not include an ETA because there is none to compute. The React layer compares the per-story estimates from priority_list against the epic's total story count and shows the "ETA pending" indicator when a story is missing one.

Full envelope
{
  "jsonrpc": "2.0",
  "method": "tools/call",
  "params": {
    "name": "epic_progress",
    "arguments": { "slug": "the-moon-watch" }
  }
}

Next: Release markers are date stakes →
